We took every one of the 1,425 projects on UP-RERA's register across Gautam Buddh Nagar (Noida and Greater Noida) and Ghaziabad, and compared each one's declared completion date — the date the developer itself filed with the regulator — against the calendar. 1,008 of them, 70.7%, are already past that date. Not our deadline. Theirs.
What "past its declared deadline" means — and what it doesn't
Every RERA-registered project commits to a completion date at registration. We flag whether that date has passed. It is a fact from the public record, not a verdict: a project past its date may have finished late, or may still be under construction. UP-RERA gates the live construction-progress data behind a login, so the declared timeline is the honest, fully-public signal — and on this measure, the Noida region's record is stark.
By district
| District | Registered | Past deadline | Share |
|---|---|---|---|
| Noida & Greater Noida | 957 | 677 | 71% |
| Ghaziabad | 468 | 331 | 71% |
Noida & Greater Noida carries the higher share at 71% past their declared date — the legacy of a building boom whose timelines the market never caught up to.
The builders with the most projects past deadline
Volume matters here — a developer with many registrations carries many timelines. These are the names with the most projects already past their declared completion date (minimum eight registered projects in the region):

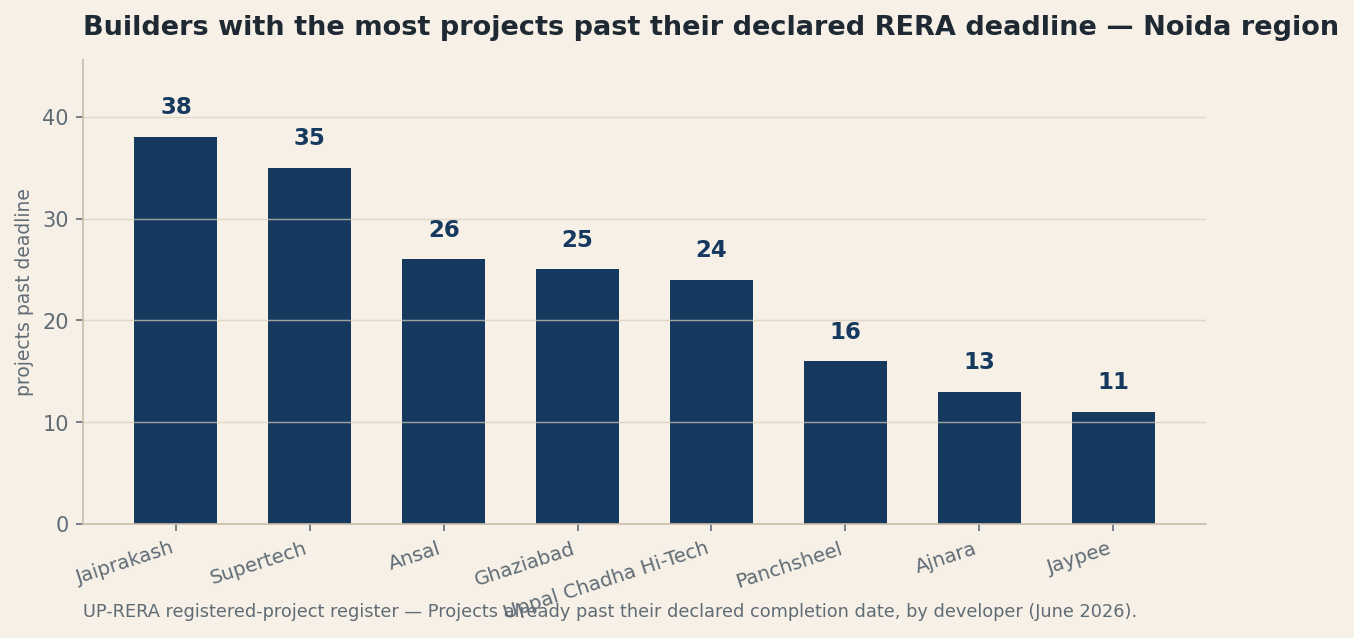

| Developer | Registered | Past deadline | Share |
|---|---|---|---|
| Jaiprakash Associates Limited | 38 | 38 | 100% |
| Supertech | 35 | 35 | 100% |
| Ansal | 31 | 26 | 84% |
| Ghaziabad Development Authority | 25 | 25 | 100% |
| Uppal Chadha Hi-Tech | 29 | 24 | 83% |
| Panchsheel Buildtech Pvt | 18 | 16 | 89% |
| Ajnara India Limited | 13 | 13 | 100% |
| Jaypee Infratech Limited | 17 | 11 | 65% |
| Greater Noida Industrial | 10 | 10 | 100% |
| Gaursons Realtech Private | 11 | 10 | 91% |
A high count isn't automatically damning — a large, long-running developer will have more lapsed dates than a boutique one — but it is exactly the list a buyer should read before signing, and exactly what the public register makes checkable.
You can check any single project yourself on our Noida project-timeline tool — declared completion date, whether it has passed, and the builder's full record.
Source: the UP-RERA registered-project register for Gautam Buddh Nagar and Ghaziabad. "Declared completion" is the date each developer filed with the regulator; "past deadline" means that date has passed as of June 2026. Figures are the regulator's own.
