A national developer sells the same promise in every city it enters. The state RERA registers let you check whether it keeps that promise — and because Quietlist holds the registers for three major markets at once, we can lay a developer's record side by side. 18 developers build across at least two of Bangalore, Gurgaon and the Noida region; 5 build in all three. Here is each one's record, in each market, from the regulators' own files.
How to read this — each regulator shows a different signal
There is no single national RERA, and the three states don't publish the same field, so we show each city's own honest signal rather than invent a common one:
- Bangalore (K-RERA) publishes a quarterly construction % — so we show how built the developer's projects are, on average.
- Gurgaon (Haryana RERA) publishes delivery — whether a project has its occupation/completion certificate — so we show the share delivered.
- Noida region (UP-RERA) publishes each project's declared completion date — so we show the share already past that date.
The three numbers aren't interchangeable — a high 'delivered' in Gurgaon and a high 'past due' in Noida describe different things. Read each against its own city. What is comparable is the footprint: how many registered projects the developer is running in each market.

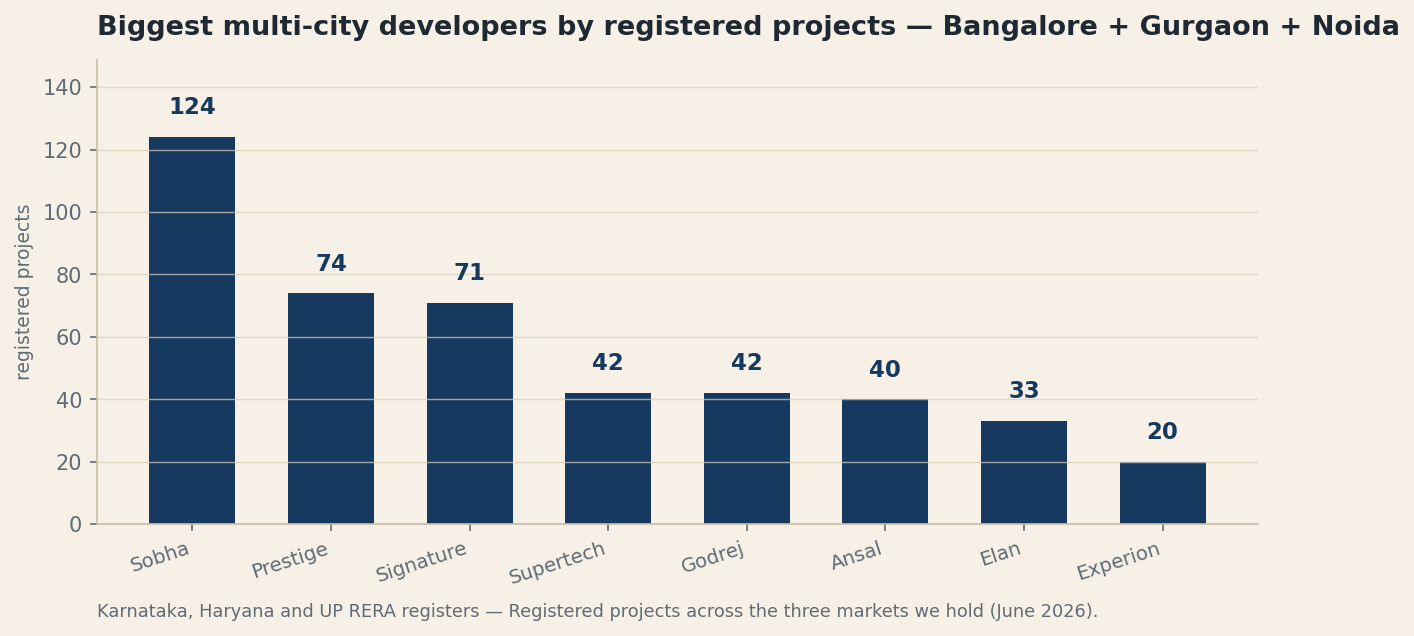

The cross-market record, developer by developer
Each cell is that developer's record in that market: registered projects, then the city's native signal. A dash means they don't build there.
| Developer | Bangalore · built | Gurgaon · delivered | Noida region · past due |
|---|---|---|---|
| Sobha | 111 proj · 64% built | 11 proj · 36% delivered | 2 proj · 0% past due |
| Supertech | 2 proj · 100% built | 5 proj · 0% delivered | 35 proj · 100% past due |
| Godrej Properties | 19 proj · 41% built | 18 proj · 17% delivered | 5 proj · 0% past due |
| Pyramid Infratech | 3 proj · no filings | 14 proj · 86% delivered | 2 proj · 50% past due |
| Imperia | 3 proj · 84% built | 3 proj · 100% delivered | 8 proj · 75% past due |
| Prestige | 68 proj · 65% built | — | 6 proj · 17% past due |
| Signature Global | 10 proj · 58% built | 61 proj · 28% delivered | — |
| Ansal | — | 9 proj · 0% delivered | 31 proj · 84% past due |
| Elan | 7 proj · 0% built | 26 proj · 23% delivered | — |
| Experion | — | 17 proj · 65% delivered | 3 proj · 0% past due |
| Adarsh | 18 proj · 64% built | — | 2 proj · 0% past due |
| Ramprastha | — | 5 proj · 40% delivered | 10 proj · 30% past due |
| BPTP | — | 9 proj · 44% delivered | 1 proj · 100% past due |
| Mahindra Lifespaces | 7 proj · 47% built | 3 proj · 67% delivered | — |
| Eldeco | — | 3 proj · 0% delivered | 6 proj · 17% past due |
| Ameya Commercial | 3 proj · no filings | 5 proj · 0% delivered | — |
| Ambience | — | 2 proj · 0% delivered | 4 proj · 25% past due |
| Orris | — | 5 proj · 0% delivered | 1 proj · 100% past due |
A wide footprint isn't a verdict — a large developer naturally carries more of everything. But seeing one brand's record across three regulators at once is exactly the check a buyer can almost never do, because the data lives in three separate state systems. We hold all three.
What this means if you're buying
Brand reputation travels between cities; performance doesn't always follow. A developer that delivers cleanly in one market can run late in another — different land, different approvals, different local team. Before you trust a national name, look up its record in your city's RERA register, not the city its reputation was built in.
Looking at a specific project from one of these developers? We hold the full RERA record — construction filings, delivery status and declared timelines — across all three markets. Tell us the project and we'll send you its record.
Methodology: built from the Karnataka, Haryana and UP-RERA registered-project registers as of June 2026. A developer is included when it has registered projects in at least two of the three markets and at least 6 in total. 'Built' is the mean of each Bangalore project's latest reported construction %; 'delivered' is the share of Gurgaon projects with an occupation/completion certificate; 'past due' is the share of Noida-region projects past their declared completion date. We group registration entities to the consumer-facing developer brand. All figures are developers' own RERA disclosures.
